Good PMO reporting with the right PMO reports will allow target groups to discern the current state in their project environment quickly. Decision-makers should see at first sight what they have to decide. This saves valuable time and effort.

This article introduces you to the requirements for reports in project, portfolio and resource management. You will learn what information is relevant for the stakeholders and how reports contribute to fast decisions. In addition, you will get tips for efficient data collection and data quality checks. Lastly, there is a checklist of the ten most important questions to help you set up your reporting system.

We will look at the following topics:

As part of the article, you also receive a checklist on reporting and examples of possible content for individual reports which would be useful for you as the PMO.

Let us begin with who is responsible for the contents of reports.

Special Download: How to set up a PMO in 4 simple steps (PDF file)

Why Project Reports Should Be at the Beginning

The Project Management Office (PMO) is responsible for the reports in project and portfolio management (PPRM).

This task encompasses not only the structure and the selection of the information presented. Among the PMO functions there is another important task that is not always easy. The PMO has to ensure the quality of the reports with regard to currency, correctness and the requirements of the target groups.

In a study, Gartner arrived at the following conclusion:

PMOs often do not provide the data senior managers need. This creates a gap between expectation and reality. More data is not automatically better. PMOs should adapt their reports step by step to make sure they really support executives. Senior managers do not have much time. They need short, precise and clear information. The PMO should collaborate with them and provide exactly that.

Source: “Seven Best Practices for an Effective Project Management Office”, Gartner, 2016

The problem: when introducing project and portfolio management solutions (PPRM) the reporting topic is often considered too late.

Does that sound familiar?

It would be ideal if your PMO reports came right at the beginning. In such a case, the PPM system would be planned around the reports and the needs of their users.

Reading tip: ROI Calculation for PPM Tools: Making Informed Decisions

After all, only very good project management reports make you realize what is happening and what needs to be decided with more or less urgency. You will only get the most out of your PPRM system, if you focus on the essentials and take into account what the recipients of the reports expect.

But this is only half the battle. To enable you to react to the developments in the project environment really fast, your reports need to be up to date and flexible, too.

Below, you will read about the requirements for reports in project, portfolio and resource management.

Special Download: 10 Vital PMO Success Factors (PDF file)

Requirements for PMO Reports in Project Management

These days, IT solutions allow you to present reports in project management quickly on the screen, both in color and in the desired level of detail. When it comes to what information e.g. a PMO envisions for the company, we know from our consulting experience that classic fixed notions for project management reports come into play. They are expected to be:

  • In color
  • Permissions
  • Fast / at the push of button
  • Modifiable
  • Indestructible
  • Readable
  • Filterable
  • Intelligible
  • Detailed
  • Correct
  • Concise
  • Everything on one page (DIN A4 portrait format)
  • Printable
  • Possible to historize

Accommodating these wishes in a single document is not easy. The actual reporting requirements are more realistic. They can be summed up in one sentence:

Actual reporting requirements in a nutshell: you must make relevant information available to the right people in a meaningful and efficient way to control projects optimally.

So, you should always ask yourself the following questions when setting up a reporting system:

  • What do I aim to plan and control?
  • What information will I require for this?
  • Which level of detail makes sense?
  • What do I want to achieve with which report?
  • Who will be working with the reports afterwards?
  • Will the target group of the reports be able to grasp the contents?

Our tip: Honest answers to these questions are an important prerequisite for your future reports. Their creation needs to be efficient, without unnecessary data baggage. A prior stakeholder analysis to determine the needs of the different roles is advisable at any rate.

PMO Reports for Different Stakeholders at the Company

As a rule, every company has several different levels requiring different reports. The higher up in the hierarchy, the more condensed the information needs to be.

Still, a drill-down to the details needs to be possible on demand. This allows users to comprehend the consolidated report information in the case of inquiries.

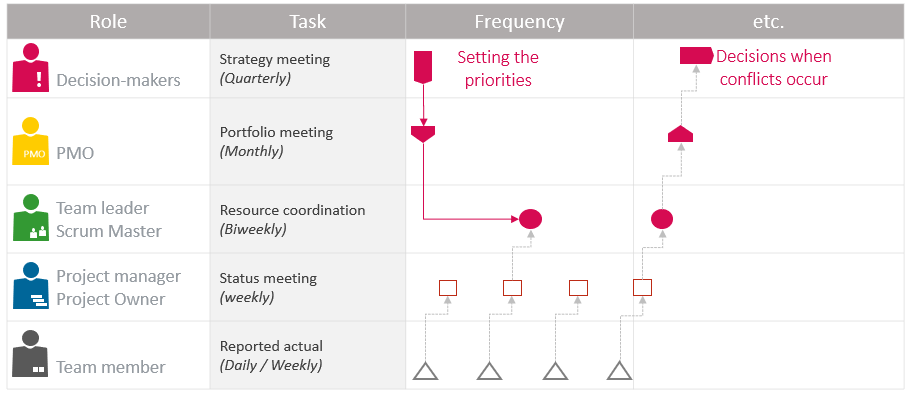

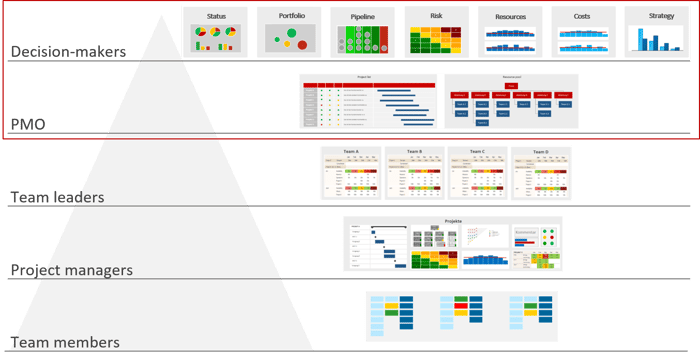

PMO Reports – Sketch of reporting levels
Sketch of the reporting levels at the company with possible reports
Decision-makers
Top management requires consolidated information for management control on a regular basis. For instance, they consider the adherence to the strategic focus, risks or investment risks.
PMO
The PMO is the body that often prepares the reports on projects and resources at portfolio level for top management. It requires a project list with the status to be able to check with project managers when this seems necessary. Any escalations identified are reported to the top for decision-making.
Team leaders
Team leaders are responsible for their resources. For this, they require the corresponding overviews of their teams’ workload and availability. In addition, they need to be able to make reliable resource commitments for projects to the project managers.
Project managers
When planning individual projects, the project manager uses e.g. the status report, the work breakdown structure, the milestone overview or possibly a Milestone Trend Analysis.
Project team members
Project team members want to see their work packages. What is more, they are interested in who else is working on the project and in time tracking. This is less about classic reports but more about available information.

Note: To demonstrate the benefits your PMO provides you should define a set of key performance indicators and align them with your stakeholders. The right PMO KPIs will assist you in this endeavor.

Reporting Periods in the Project Environment

Reports are the basis for coordination meetings. They help us understand what is happening at the company at this moment. And where decisions are at present necessary.

The higher up in the hierarchy, the more condensed the information and the less frequent the reporting.

The figure below clarifies how the reporting periods at the individual levels result from the individual meetings. Relative to the hierarchical level, the information becomes increasingly condensed while the frequency of reporting decreases accordingly.

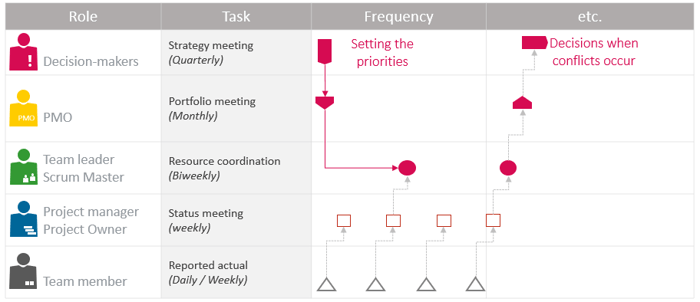

PMO Reports – Reporting periods
Reporting periods in project and portfolio management

What decisions may or must be made where? Subject to this, you must ensure that the required information is available in the form of meaningful reports.

In the process, you also need to decide which element is useful for which report. You do not need a wealth of data in every report, but its message must be easy to understand. You must aim for maximum clarity and intelligibility in your reports.

What Reports Make Sense?

The question of which reports are useful always requires a very individual answer. The figure below provides an overview. It shows which reports make sense across the hierarchies. Naturally, this depends to a large extent on your company’s:

  • size
  • processes
  • industry

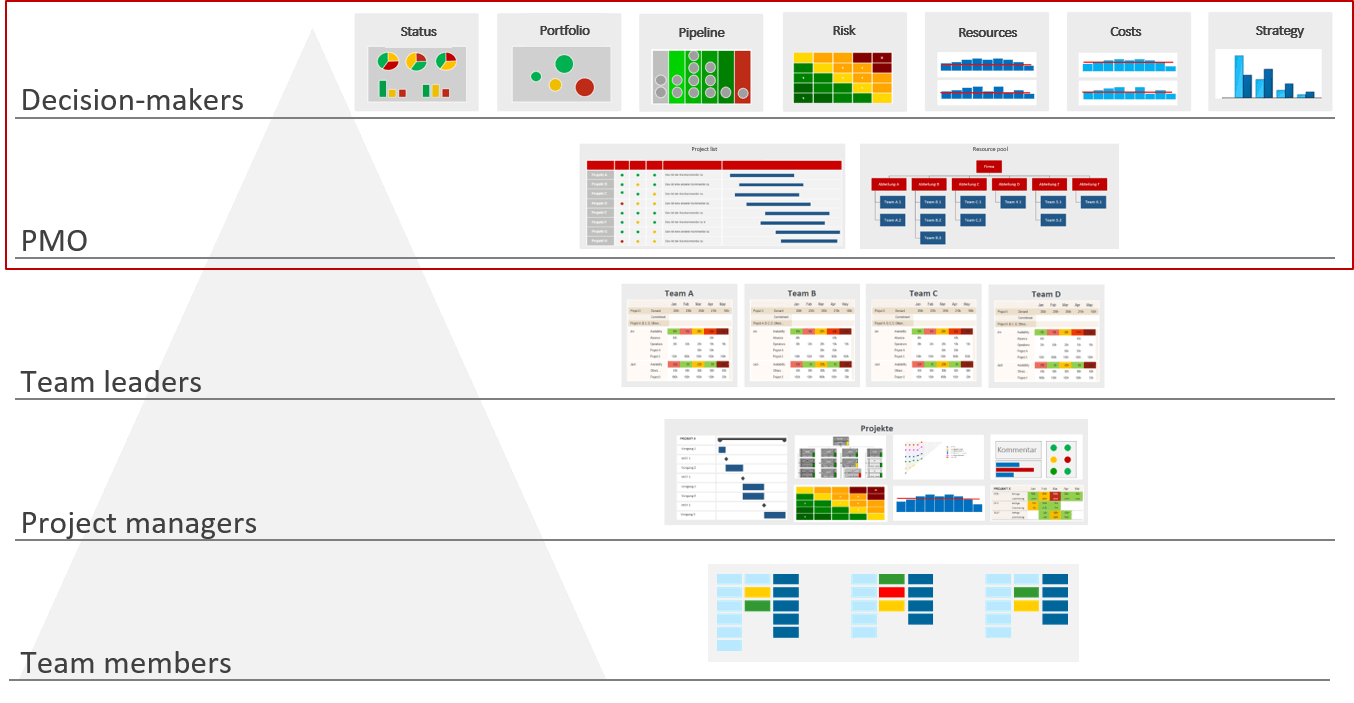

PMO Reports – Reports in the hierarchy
Example of useful reports in the hierarchy of the company (source: The PPM Paradise)

Unfortunately, there is no ONE project management report that is right for all. While reports tend to look similar, you must always adapt them to the respective processes and needs of the company. This always depends on the intended use and the recipients.

It might help you to work out the reporting requirements and their possible implementation in a workshop with important stakeholders and the support of an experienced PMO consultant.

Below, you will find an overview of possible reports from the PMO environment.

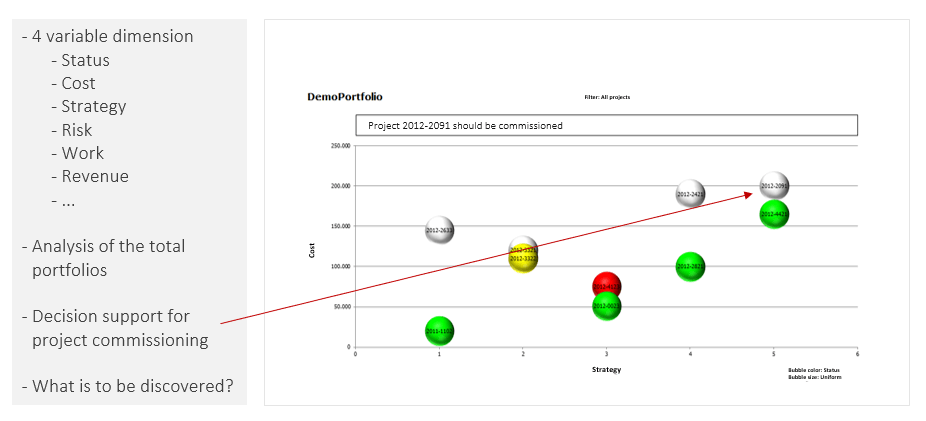

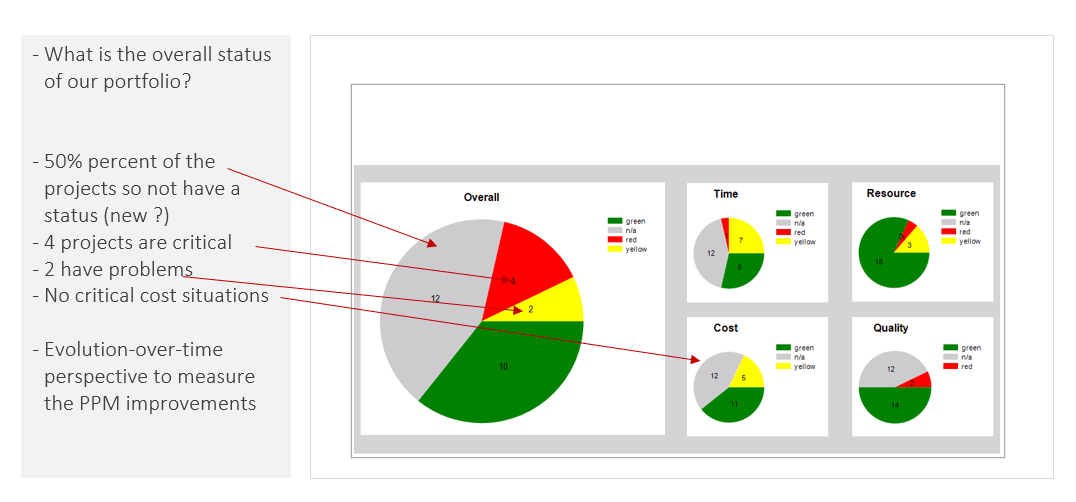

Report Showing a Portfolio Dashboard (Example)

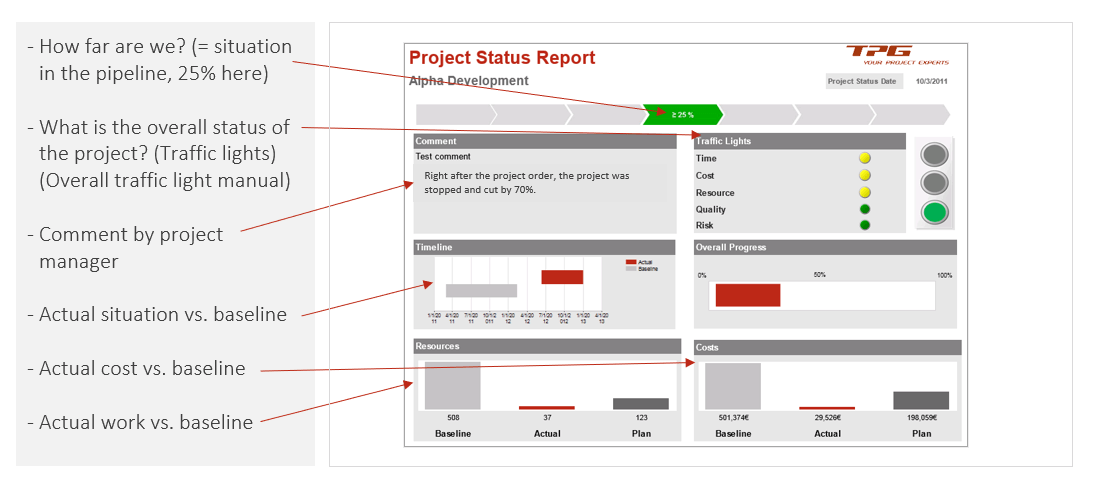

PMO Reports – Status report portfolio

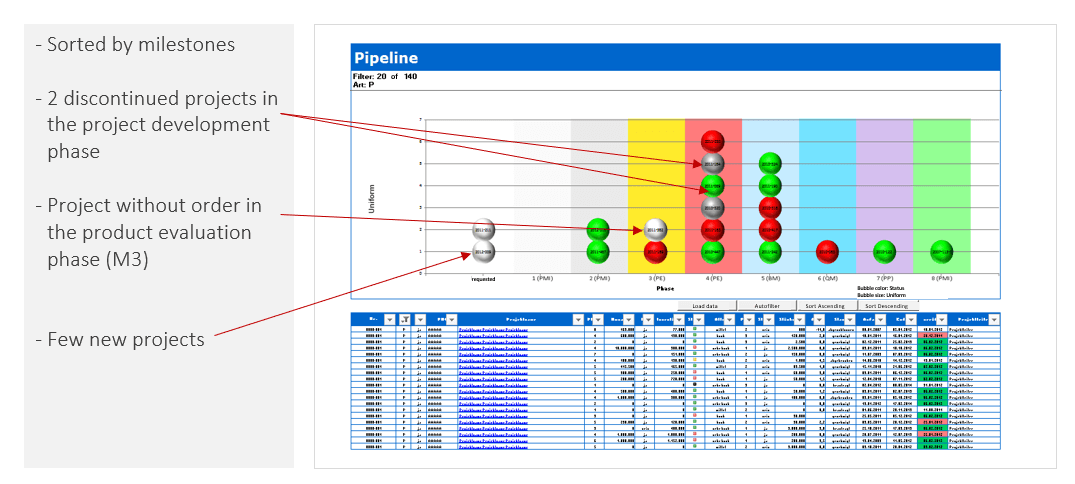

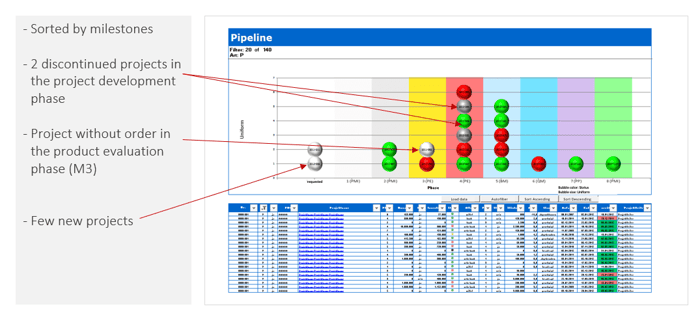

Project Pipeline Report (Example)

PMO Reports – Project Pipeline Report

Report for Resource Utilization & Roadmap (Example)

PMO Reports – Resource Utilization Portfolio

Project Status Report (Example)

PMO Reports – Simple project status report

Learn more in our article on contents and creation of the Project Status Report.

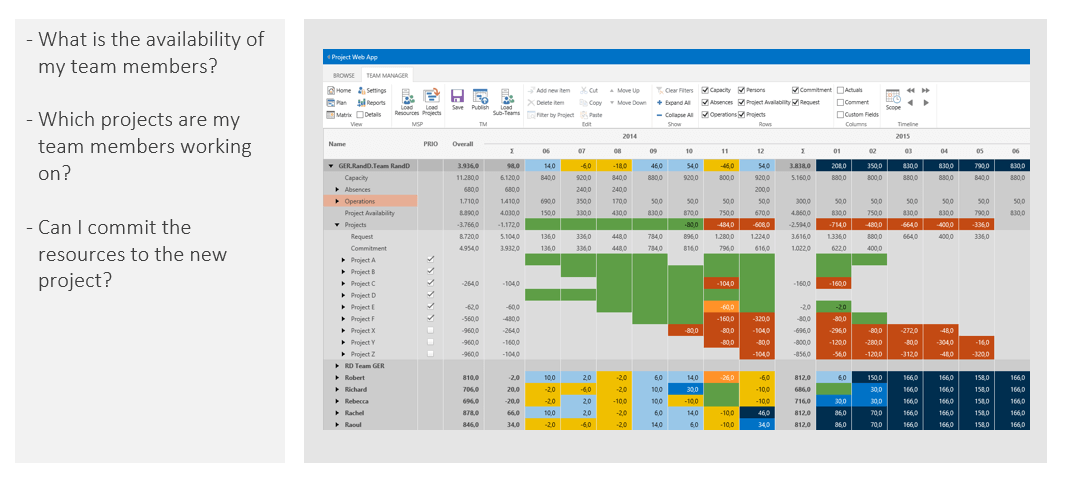

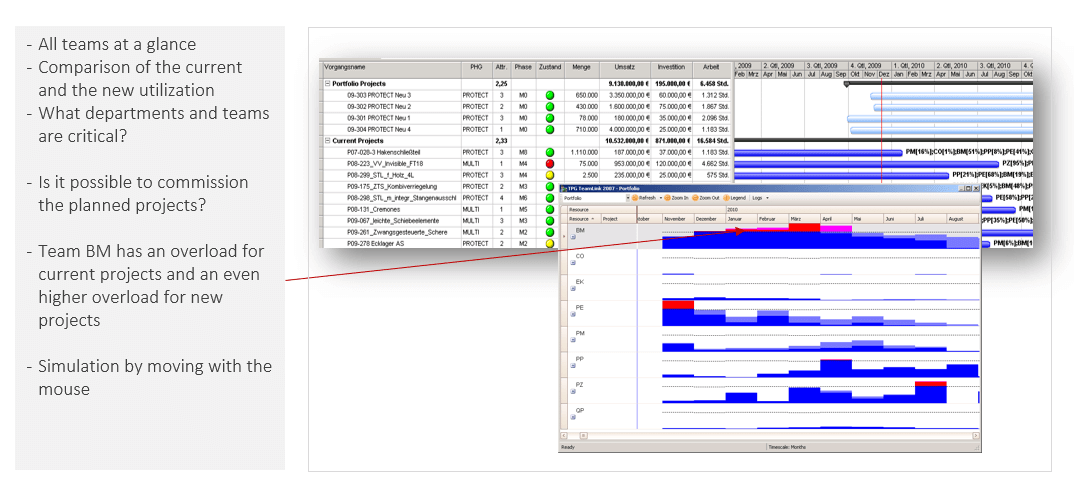

Report for Team Planning and Utilization (Example)

PMO Reports – Team planning

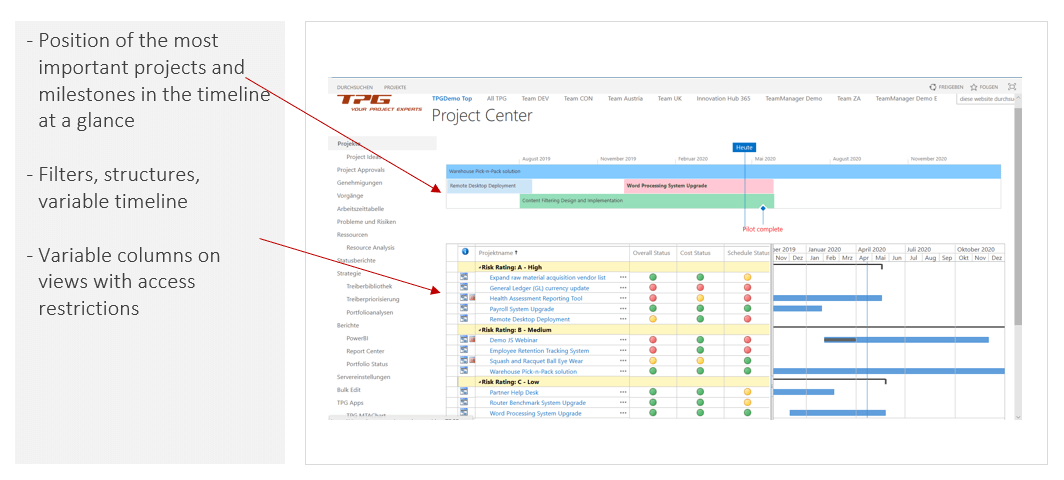

Project Overview as an Interactive Website (Example)

PMO Reports – Project overview as an interactive website

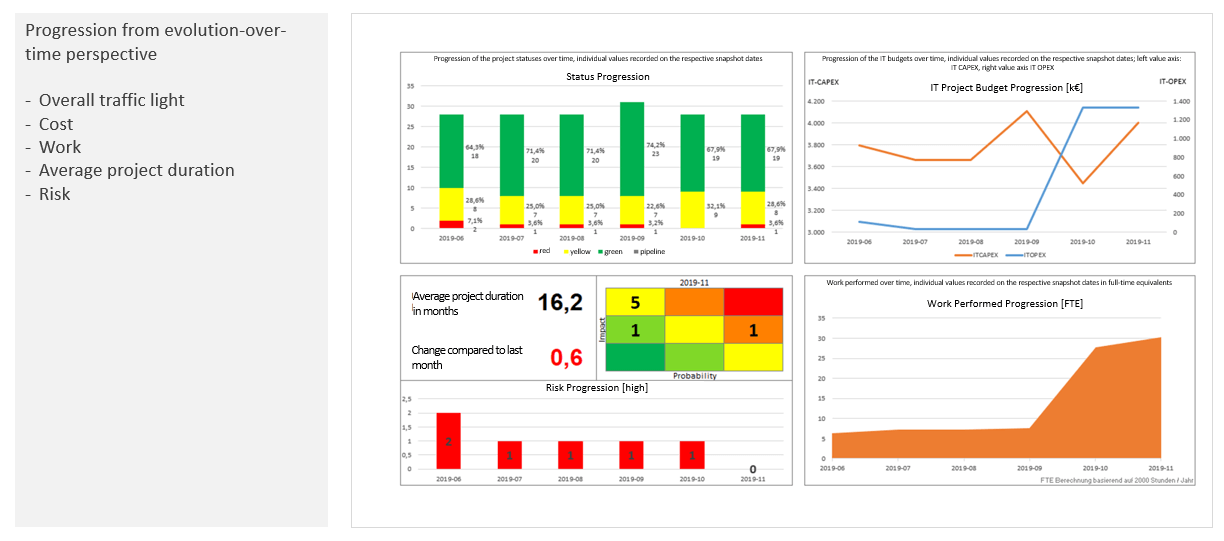

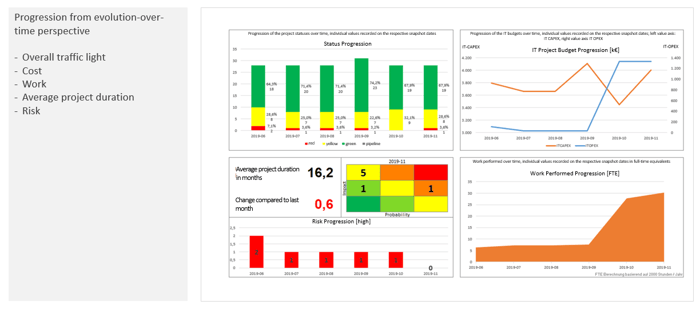

Current Status of the Portfolio (Evolution-Over-Time Perspective, Example)

PMO Reports – Example: Current status of the portfolio (evolution-over-time perspective

Current Developments (Example)

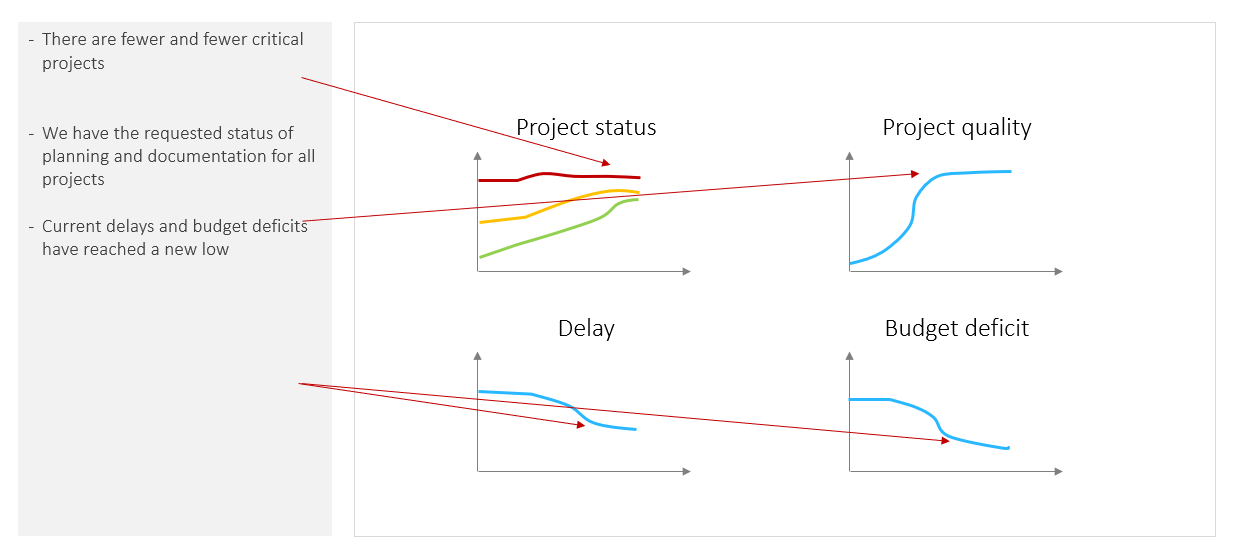

PMO Reports – Current development

Review of the Portfolio (Example)

Review of the Portfolio

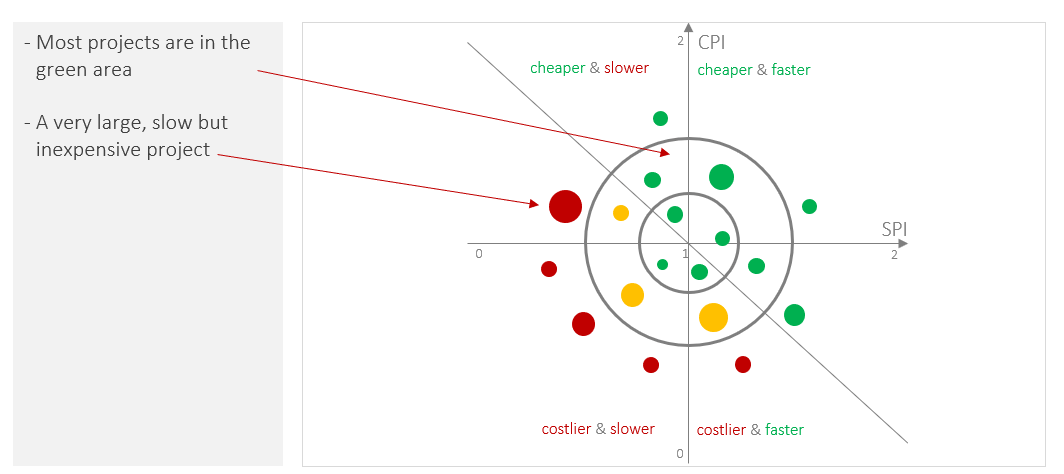

Earned Value Indices (Example)

Earned value indice

Find more information on Earned Value Analysis in this article.

Our tip: As the PMO, it is wise to keep an eye on the number of reports. Over time, this is very likely to increase, as new ones tend to be added continually. A periodic consolidation can ensure that your reporting retains its efficiency as a whole.

Selection in the Multi-Project Environment

Often, the PMO is responsible for the preparation of the portfolio meeting. In a multi-project environment and in project portfolio management, the selection of projects is a particular challenge. From the project portfolio, which can be very substantial, you need to specifically select certain projects which are to be covered in the time available for the portfolio meeting.

The right selection process ensures that the need for decisions is identified early, enabling you to make the necessary decisions in the time available.

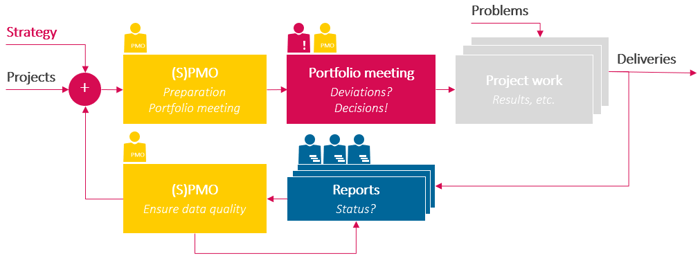

Preparing a project portfolio meeting
Portfolio control process by the PMO in the multi-project environment

The following list provides criteria by which you in the PMO could make a project selection for the project portfolio meetings:

  • Declared need for decisions (manually set indicator)
  • All projects with status RED (Overall, resources, schedule …) + 3 YELLOW + 3 GREEN (as samples to check for data quality, more detail further below)
  • All projects in the top 3 risk categories
  • Top 10 in terms of variance (cost, schedule, work)
  • Top 10 strategic contribution / priority
  • All projects above a threshold value (order / investment volume, contractual penalty …)
  • Problem areas (technology, regions, project manager, product categories …)

Subscribe to the TPG Blog Newsletter now and never miss another blog post.

Possible Contents for Reports of Individual Projects

What information should you provide in the reports of individual projects? Suggestions for results, deliveries and states could be:

  • Achievement of milestones (standard milestones)
  • Completion of phases (phase model)
  • Acceptance of deliveries planned / effected (payment milestones)
  • Completion of work packages / deliveries (definition of “done”)
  • Completion of tasks (not started / in progress / completed)
  • List of open issues (open / started / completed)
  • Earned Value Analysis (Baseline and %Physical Complete)
  • %Complete (no appropriate statement below 100% … 99% syndrome, i.e. the danger of the permanent 99% value)

For quality assurance, the report should include plausibility checks, such as:

  • Comparison between remaining effort and reported stage of completion
  • Relation between %Cost / %Work / %Time / %Physical Complete (relation of the values to each other)

To determine the plan-actual variance we recommend the following information:

  • Deliveries: Plan / actual of quality, scheduling, effort, cost
  • Work outstanding: Clarity of proof of concept, work / budget, cost / budget, schedule / plan
  • Resources: assign, shift, withdraw

When it comes to decisions on the next steps, the following information is helpful:

  • Order / follow-up: entered or not (continue regardless?)
  • Budget: available or too low (continue only after increase?)
  • Resources: committed or too few (escalation or postponement?)
  • Risk situation: manageable or unfavorable (any known alternatives?)
  • Chosen option: Method A or B (documentation of the decision including reasons)

Once your PMO has prepared the meeting, it is important to ensure one thing. During the meeting, the necessary data to provide answers to the decision-makers’ questions must be available – preferably at the push of a button.

Our tip: The report after a meeting is also an important medium. Communicate the results of the meeting to all parties concerned. This is the only way to make them adjust their further actions to the results of the meeting.

Find further detail about report contents in our PPM Report article.

Efficient Data Collection as the Basis for PMO Reports

At many companies, collecting the data for the reports takes longer than the actual analysis and preparation. For you, too?

You can handle this much more efficiently once you do not have to collect various Excel files and consolidate them.

It is best to work with a suitable database from the start. This database should allow you integration with other systems through integration middleware and central data evaluation for reports. This leaves you with more time for the analysis of the reports. The analysis in turn enables decision-makers to make well-founded and fast decisions based on up-to-date data.

Get to know the results of a survey on PMO / PPM Tools conducted by TPG in 2024.

Ensuring Data Quality

The PMO is also responsible for ensuring the reports’ data quality. But how do you recognize whether the data of a project report is complete, correct and up to date?

The challenge is to determine which projects vary from the plan, e.g. with the aid of plausibility checks. Is the stage of completion, which the project manager indicated in the project report, actually correct?

Among other things, the following information can help you check whether the data is complete, correct and up to date:

1. Complete

  • All projects (vs. operations)
  • All deliverables per project
  • All relevant resources with all activities (project availability)

2. Correct

  • Check for planning plausibility
  • Complete coverage of all cost types and efforts
  • Stage of actual completion

3. Up to date

  • When was the data entered?
  • At what time was the transfer of data from external systems?
  • When were the reports created?

Our tip: Use samples to improve data quality. Project managers have a tendency to make their reports look particularly inconspicuous. As the PMO, you should therefore pick out a few projects with green status alongside those with red and yellow status indicators. This takes away the certainty from project managers that a green traffic light will keep them “off the radar”.

Checklist on Reporting and Determining Factors

Do you want to modernize your PMO reporting? This checklist with the ten most important questions can help you to think in the right direction:

PMO Reports Checklist

Checklist: The 10 Most Important Questions on PMO Reporting

1.   Who should have permissions for what?
2.   How often should the data be updated?
3.   How often should the reports be issued?
4.   Do the reports have to be available online or offline?
5.   Do you require ad-hoc analyses?
6.   Will the reports need to be printed?
7.   Should there be an option to comment on reports?
8.   Does the data need to be historized?
9.   Will the reports need to be archived?
10. Do you wish to be able to modify reports?

Below, you will find a few additional notes on some important points from the list.

Permissions control who is allowed to see what. If you decide for too much complexity, adjustments can become very complicated when people change roles. It is also important to involve the employee organization regarding the internal resource data.

Comments in reports should point very clearly to issues that require particular attention. This enables readers to grasp critical points quickly. Explanations for the states presented are also advisable. For instance, they might clarify why a traffic light is red.

If a report is historized, that means the state of the report on a particular date can be retrieved at a later stage. On the one hand, the underlying data from that time needs to be available. On the other hand, the original layout of the other page needs to be recoverable pixel by pixel. Archiving is best managed by creating PDFs. It is possible to save them automatically to a database. In such a case, they can be retrieved specifically in their original version, even after a long time.

Our tip: Use standard tools! If you in the PMO are able to modify reports, you have greater flexibility. For this reason, you should use standard tools as much as possible. You can make changes as required, fast and without external help.

PPRM Tools for Modern PM Reports

Do you lack visibility in your project environment? Are you struggling to maintain an overview due to time-consuming and error-prone manual reporting? In this case, you are not working with advanced PPRM software that is tailored to your needs and eliminates these problem areas.

Take a look at TPG ProjectPowerPack, the tool based on Microsoft 365 and Power Platform. This modern environment provides you with 40 reports at the touch of a button: on the project status, resource utilization and the portfolio. This allows you to control your entire project portfolio with KPIs – if desired also based on data from integrated external systems.

TPG Blog: Sample project status report in TPG ProjectPowerPack
Sample project status report in TPG ProjectPowerPack

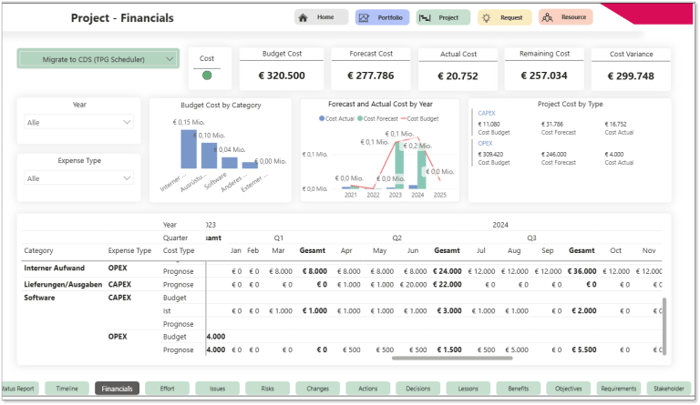

TPG Blog: Sample project finance report in TPG ProjectPowerPack
Sample project finance report in TPG ProjectPowerPack

Conclusion – PMO Reports for Project, Portfolio and Resource Management

In this article, you have found out what requirements PMO reports in project, portfolio and resource management should meet.

You have learned:

  • That you require different depths of information and frequencies of coordination for the different stakeholders at the company
  • Which criteria are important for a project selection when preparing your next portfolio meeting
  • What information you should be able to find in reports
  • How you cater for quality assurance, record plan-actual variance, and prepare decisions on the next steps.

In addition, you have found out:

  • That an efficient data collection is the basis of a fast and reliable reporting system
  • How you can check whether the data is complete, correct and up to date

Lastly, a checklist has familiarized you with the 10 most important questions on reporting – as a guideline for your next steps.
